Holland Charter Township - Pump Station No. 31 & Force Main Replacement

Project Information

Holland Charter Township will be constructing new wastewater utilities, starting from the City of Holland Treatment Plant south of Macatawa River (near 1st Street and River Avenue), extending to the north end of the township near John F. Donnelly/Quincy Street.

The project will include road closures, utility excavation/installation, pavement removals (road, pathway, driveway), and restoration activities.

The contractor (K&R) plans to begin work at the south end of the project this August (2024) and work their way north through 2025.

Mail

Temporary mailbox location may be installed. Contractor will coordinate with residents.

Garbage Pickup

Contractor may request trash receptacles to be replaced at the road the night before.

Access/Traffic
  • Emergency vehicle access will be maintained.
  • Local resident access will be maintained, and coordinated with the contractor.
  • There may be times where access will be limited to your home during construction activities. Contractor to coordinate alternate parking locations.

Contact

Contractor
Kamminga & Roodvoets, Inc. (K&R)
Adam Khodl, Project Manager
(616) 949-0800
khodlad@kandrinc.com

Prein&Newhof (Engineer)
Jonathan Nelson, PE, Project Manager
(616) 432-6741
Jnelson@preinnewhof.com

Jesse Boogaard, Construction Observer
(616) 394-0200
jboogaard@preinnewhof.com

Holland Charter Township
Aaron Nyboer, Director of Public Works
(616) 396-1891
aaronn@hct.holland.mi.us



Progress Report:

The Spring 2025 update video can be seen below, showcasing the work completed over this past winter and early spring. This includes HBPW electric corridor and James Street force main installation, CSX railroad bore & jack (42-inch casing installation), and pump station site preparation.

Pump station progress continues as the station’s wet well walls are being constructed this week. The wet well is the holding tank for the wastewater that is received from the gravity system upstream, prior to being pumped downstream to the treatment plant.

Force Main Progress:

The bore & jack has now been completed under the CSX railroad. The HDPE force main is now installed within the 42″ diameter steel casing. K&R this week is working on the force main installation along River Hills Drive.

Upcoming Work:

Pump station wet well construction will continue, along with the Lakewood Blvd bore & jack and open cut force main installation along River Hills Drive.

Pump Station Progress: K&R continues to move forward with the pump station work. The rail system has been installed extending nearly 30′ deep for the installation of the wetwell. This pump station is replacing the existing wastewater pump station across the street once complete and will have a higher capacity to take in additional growth in the area.

Force Main Progress: Pipe installation along James Street is nearing completion as K&R works to restore this portion of the project. The bore & jack operations have begin near the Wesco gas station north of River Hills Drive. This is a key element for the project, as the utility crossing under the CSX railroad. K&R and their boring subcontractor Lowe plan to have the casing under the tracks completed by the end of this week (April 5th).

Upcoming Work:

Pump Station Progress: Wetwell walls plan to be formed in preparation for concrete pour in the coming weeks.

Force Main Progress: Lowe will move to the next bore & jack under Lakewood Blvd in the coming weeks. Once the casing pipes are installed, the HDPE force main carrier pipe can but pushed inside the casing. K&R will be installing force main pipe along River Hills drive, starting at the railroad tracks and install south.

Progress Report:

New Pump Station site work continues as K&R finalizes the trench box rail system installation in preparation for concrete work in the coming weeks. These rail systems are used to minimize site impact due to trench excavation and ensure safe work conditions.

Upcoming Work:

Next Steps: Pump Station No. 31 concrete work for the wet well and the CSX/Lakewood Blvd bore & jack operations to begin later March and extend into May.

Progress Report: K&R has completed most of the mainline force main installation along HBPW Electric corridor, and has moved to installation along James Street, starting at Beeline Road and working west. Installation along James Street should be complete by early next week (February 17). Daily lane shifts for eastbound traffic continue (weather dependent) to assist in safe construction practices for workers and vehicle traffic.

Next Steps: Pump Station No. 31 site preparation for concrete work (March), and the CSX/Lakewood Blvd bore & jack operations to begin later March and extend into May.

Progress Report:

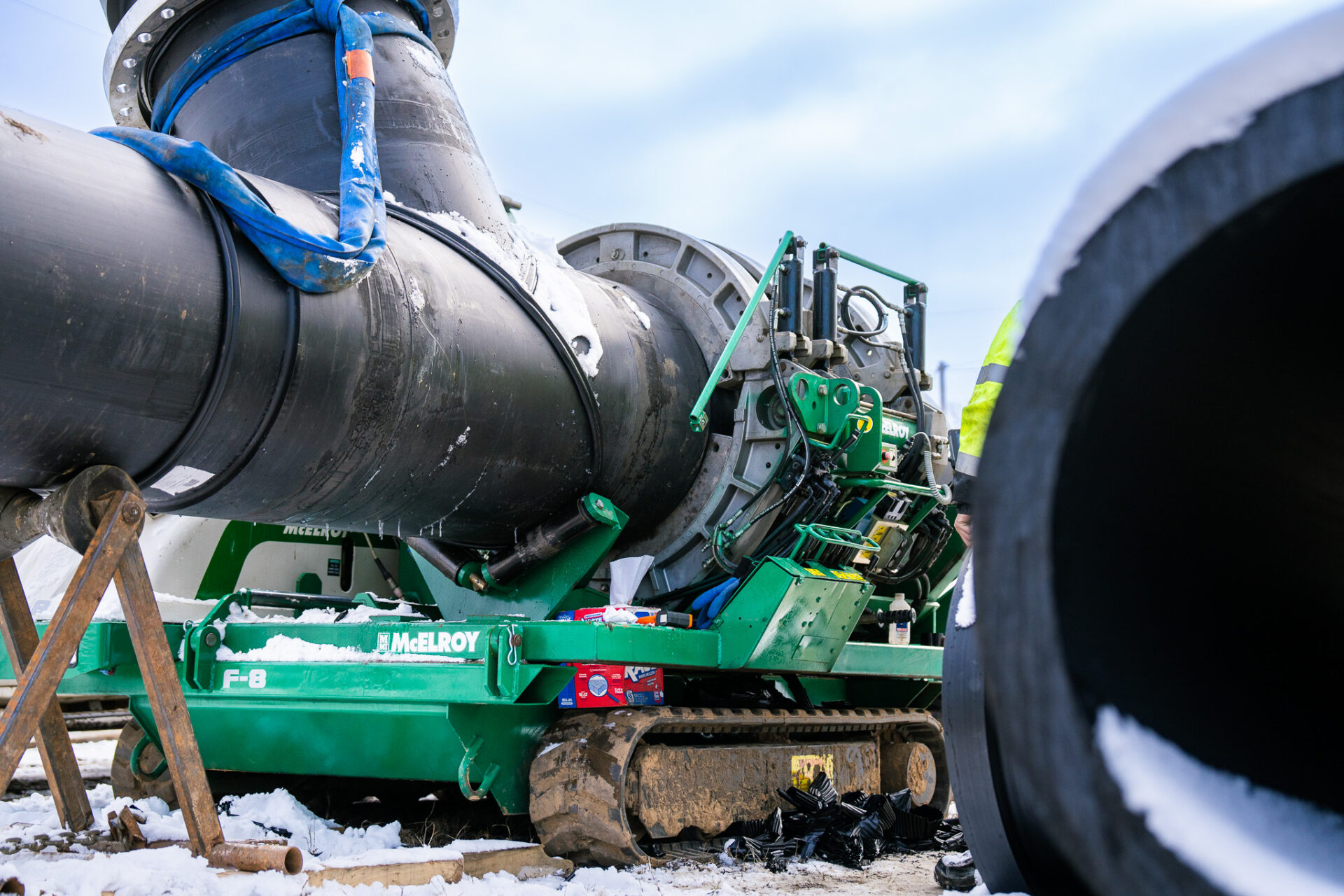

Work continues as K&R installs the 30-inch HDPE force main along between Lakewood Blvd and James Street, through the HBPW Electric easement corridor. As this work is outside the public right-of-way (ROW), this work can continue through the winter. Work is becoming more weather dependent as colder temperatures are in the forecast. The below photos show the pipe being installed in 200 – 300 feet sections at a time, along with some work fusing the fabricated tee fittings for the maintenance manhole structures. These structures are installed for access to the force main for the Township during maintenance activities.

Upcoming Work:

K&R will continue force main pipe installation along up to James Street, and will turn the corner and continue along James Street. Pump Station No. 31 site preparation and excavation may begin as early as February/March ’25.

Progress Report:

Progress continues as K&R has been working to complete the connection to the wastewater treatment plant (HAWRF), near River Ave/1st Street over the last month. This included connection to two existing force mains, pipe testing, and coordination with the Township to maintain existing flows into the plant.

River Hills Drive was temporarily restored for the winter, as more work will occur next spring.

Please find the below milestone video, outlining the work completed thus far.

Upcoming Work:

K&R will proceed with force main installation along the HBPW electric corridor between Lakewood Blvd and James Street. This is expected to extend through January/February, weather dependent.

Progress Report:

The project has hit a milestone event with the completion of the horizontal direction drill under Macatawa River. Last week, Gabe’s completed the 44-inch reamer pass while K&R fused the 30-inch HDPE pipe in preparation of the pipe pullback. Saturday (Nov. 2) the pullback was successful, taking a total of 9 hours to complete.

Upcoming Work:

Pipe testing, site restoration, and demobilization of the drilling equipment are to occur this week. Connections at the Holland Area Water Reclamation Facility (HAWRF) are to be completed shortly. K&R also plans to complete the force main (FM) installation between Lakewood Blvd and James St in the coming months.

Progress Report:

Gabe’s is nearing completion of the 44-inch ream bore (last reaming pass) and plans to be complete by next Monday (28th). K&R’s subcontractor will begin fusing the 30-inch diameter HDPE pipe today (25th).

Upcoming Work:

Tentative schedule is to pull the 30-inch HDPE pipe under Macatawa River late next week, after 2.5 months of preparation and bore work. The pipe will be strung out along the west side River Hills Drive right-of-way (ROW). Once installed, the pipe will sit approximately 60-feet below the river bottom.

Traffic/Resident Access:

Please note that as 2,000-feet of 30-inch pipe will be laid out along the west side of River Hills Drive, eastbound traffic will not be permitted to enter River Hills Drive or Scotts Drive from Lakewood Boulevard for through traffic. Residents along River Hills Drive (south of Soccer Spot), should access property from the east (via Roost Avenue). See the below detour.

default

Macatawa River HDD:

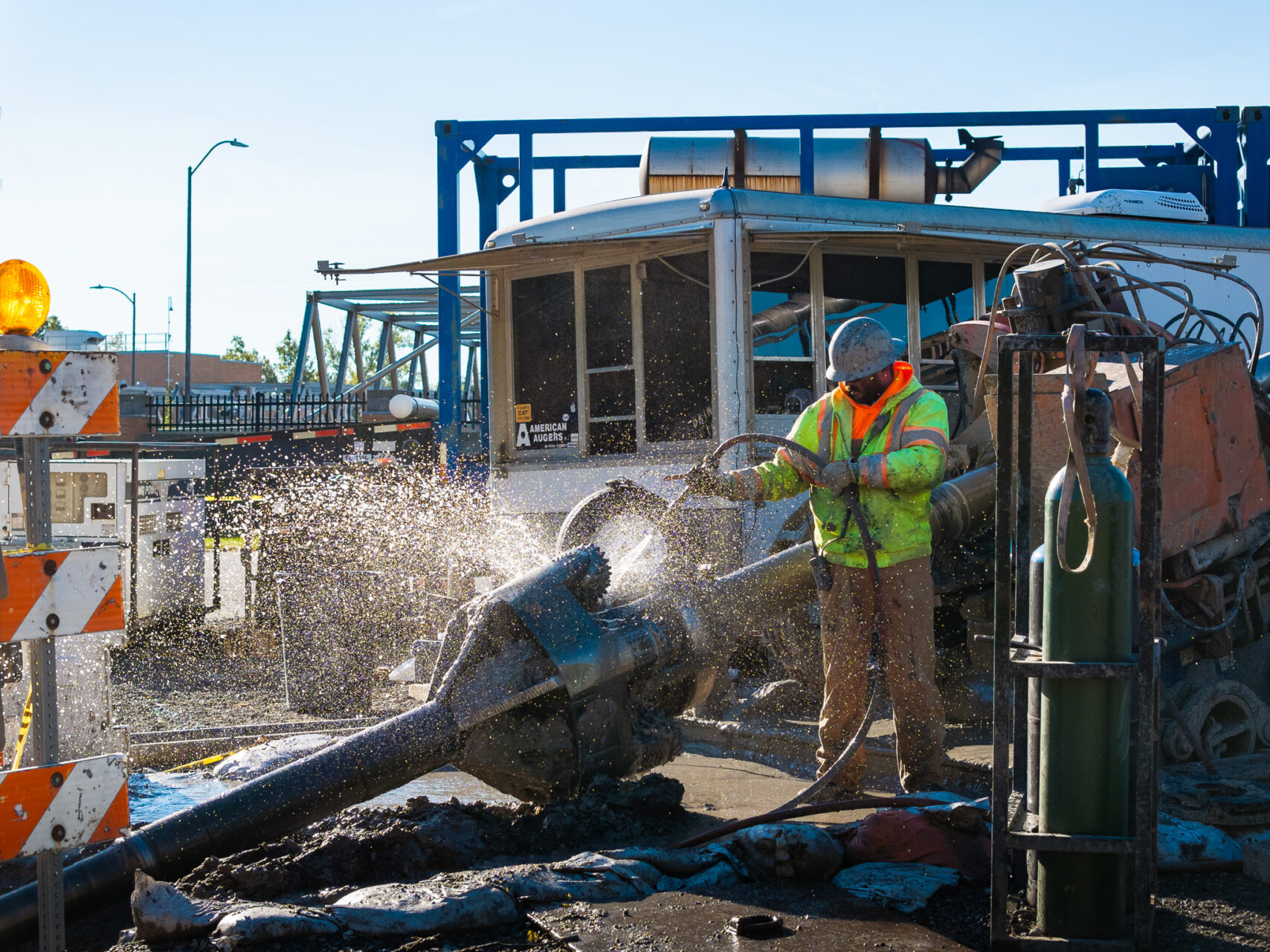

This week Gabe’s completed the second ream pass for the drill (36-inch diameter). A specialized rock reamer was used due to the soils that were encountered. Start of the final ream pass (44-inch diameter) will begin shortly, followed by the pipe pull which is expected to occur early November.

Macatawa River HDD: Reaming progress continues. Gabe’s completed the 24-inch reaming pass and began the 36-inch ream this past week (see below pictures). Once this reamer is complete, the last 45-inch reamer will be bored, followed by the HDPE pipe pull back.

Tree Removal: K&R began the tree/brush removal process in preparation for force main pipe installation this coming winter (’24) and spring (’25), mainly along the HBPW electric corridor and James Street (up to Beeline Road).

Material Delivery: Pipe and material delivery continues, as stockpiles can be seen along James Street & River Hills Drive.
