Progress Report:

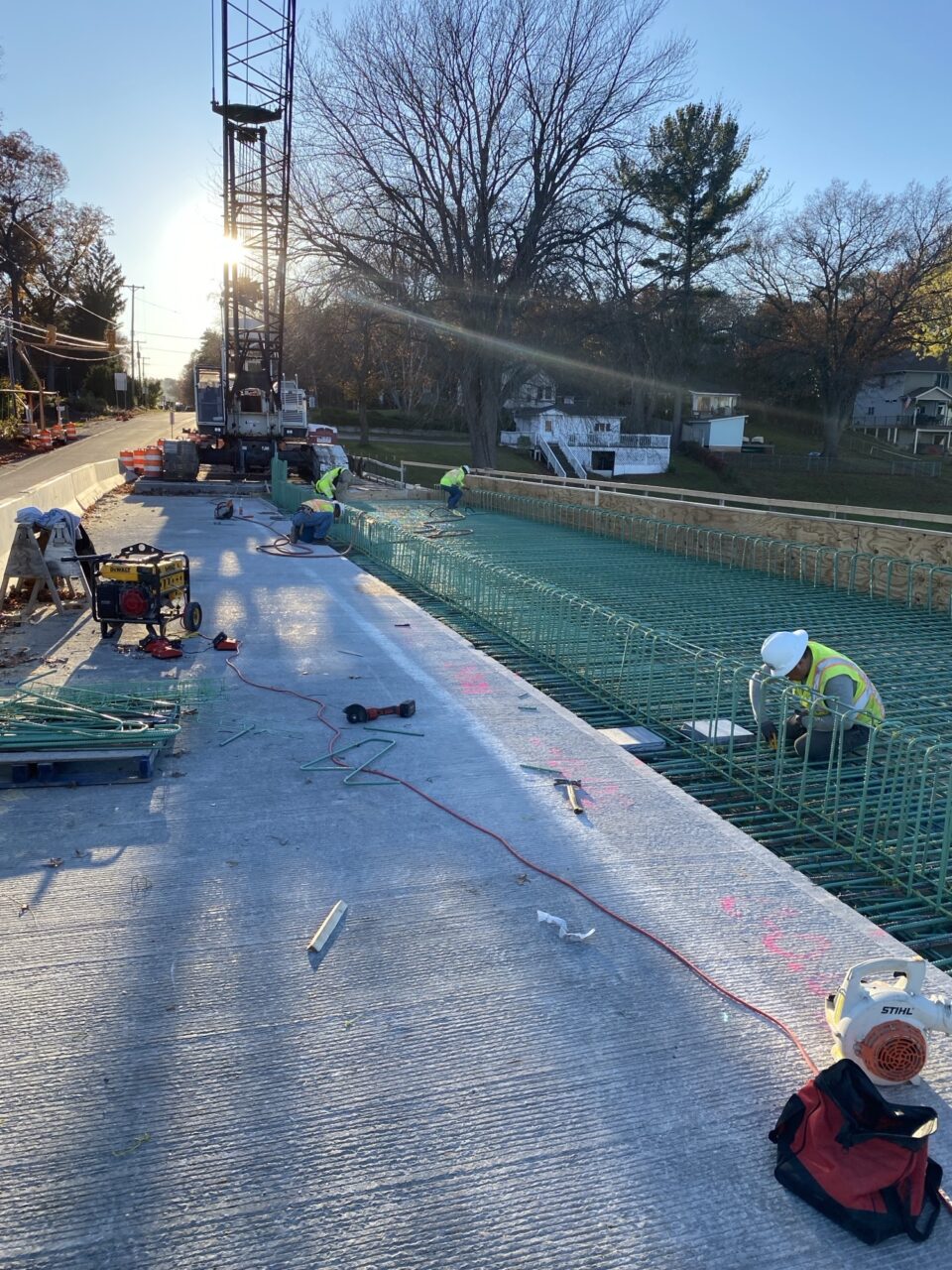

This week crews from Miller Bridge completed installing the forms and reinforcement steel for the bridge deck expansion and began to pour the deck.
On the pathway crews focused on the restoration efforts: placing and grading out the topsoil in preparation to seed.
Upcoming Work:
Next week Miller Bridge anticipates they will continue to pour the bridge deck. The deck will need to be wet cured for 7 days (this is the wet burlap underneath the plastic wrap).
On the pathway crews will begin work on the section of path along 128th Avenue in addition to restoration and more seeding.
